Enforcement quality varies by jurisdiction, and even places that enforce building codes can have properties with serious deficiencies. A permit in the seller's folder is the start of due diligence, not proof that the work was completed as approved. Price unresolved compliance risks as a separate line in your maximum allowable offer, rather than hiding them in a general rehab allowance.
Building code compliance means completed work meets the requirements adopted by the local jurisdiction for that work and occupancy. It also means required inspections and approvals are documented. A permit shows that officials authorized a defined scope; it does not prove the work followed the approved plans or passed inspection.
A permit works like an approved recipe, while inspections check key stages of the work. Final approval records the jurisdiction's closeout for the scope it reviewed. The paperwork matters, but the building itself must still match that scope.

These records answer different questions:
The gap between authorization and completed work can carry real costs. A permit may cover a bathroom renovation, while the seller also moved a wall, added circuits, or finished adjacent space. Those changes may require separate review, correction, or permits. Even a closed permit applies only to the scope documented in that record.
Practical rule: Verify that the specific work was inspected and closed. A permit on file is a starting point, not proof that the property complies.
Structural work is typically a focus of close inspection. Treat altered load paths, removed walls, roof changes, and undocumented openings as items for specialist review, not routine punch-list repairs. Unresolved work can lead to additional investigation, corrective construction, and schedule delays, so price that exposure as its own line in the maximum allowable offer (MAO), rather than burying it in a general rehab allowance.
A general inspection can identify warning signs, but it cannot replace engineering review of an altered beam or an electrician's assessment of questionable service equipment. Match the reviewer to the work in question.
For past renovations, request approved plans, inspection results, correction notices, and final approvals. Then compare the records with the physical property. The strongest evidence combines a clearly defined scope, completed inspections, and work that still matches the approved configuration.
Model codes and the rehab work that triggers them
| Code | What It Governs | Typical Investor Trigger |
|---|---|---|
| IRC, International Residential Code | One- and two-family homes and qualifying townhouses, subject to adopted scope limits | Single-family flips and BRRRR rentals; garage separation, added bedrooms, and egress |
| IBC, International Building Code | Commercial and multifamily buildings outside the residential code's scope | Small multifamily and mixed-use conversions |
| IEBC, International Existing Building Code | Repairs, alterations, additions, relocations, and occupancy changes in existing buildings | Rehabs that change systems, area, or use |
| IECC, International Energy Conservation Code | Building-envelope and energy-efficiency requirements | Insulation, window, or HVAC replacement work |
| IPC or UPC, plumbing | Water supply, drains, waste, vents, and fixtures | Moving or adding bathrooms, kitchens, or laundry |
| IMC, International Mechanical Code | Heating equipment, ductwork, ventilation, and mechanical installations | HVAC replacement or new ductwork |
| NEC, National Electrical Code | Wiring, service capacity, and circuit protection | Panel upgrades, new circuits, and service changes |
| IFC, International Fire Code, and local fire rules | Fire protection, alarms, sprinklers, and emergency access | Fire-protection work in multifamily or commercial conversions |
This is a routing guide, not a declaration that every listed code applies to your address. The adopted edition, local amendments, building classification, and project scope control. Confirm them with the building department, the authority having jurisdiction.
The International Existing Building Code contents distinguish repairs, alterations, additions, relocations, and changes of occupancy, with prescriptive, work-area, and performance-based compliance pathways. Classify the project before you ask contractors to price it.
Replacing cabinets and countertops may be cosmetic. Moving the kitchen sink to another wall changes plumbing and can require a permit, venting review, and inspection. The visible finish budget might barely change while the concealed-work scope expands.
Use these questions during the initial walkthrough:
Substantial-renovation rules can also bring additional existing-building requirements into play. Ask the department to identify the applicable trigger rather than assuming only the room under construction matters.
For plumbing planning, Modern Bathrooms' explanation of bathroom drainage and private wastewater systems is useful background on how drainage connects to the wider property. It isn't a substitute for the plumbing rules adopted locally.
Check land-use permission separately using this guide to zoning restrictions. A building-code solution won't rescue a proposed use that zoning doesn't allow.
Inspection scheduling belongs in the construction plan, not on the superintendent's memory. Colorado's state building-program policy uses a documented schedule covering foundations, under-floor areas, framing, fire-resistant penetrations, mechanical and energy work, roofing, and completion. Its practical lesson is to identify approval points before crews conceal the work.
Use this flow to establish responsibility before construction starts.

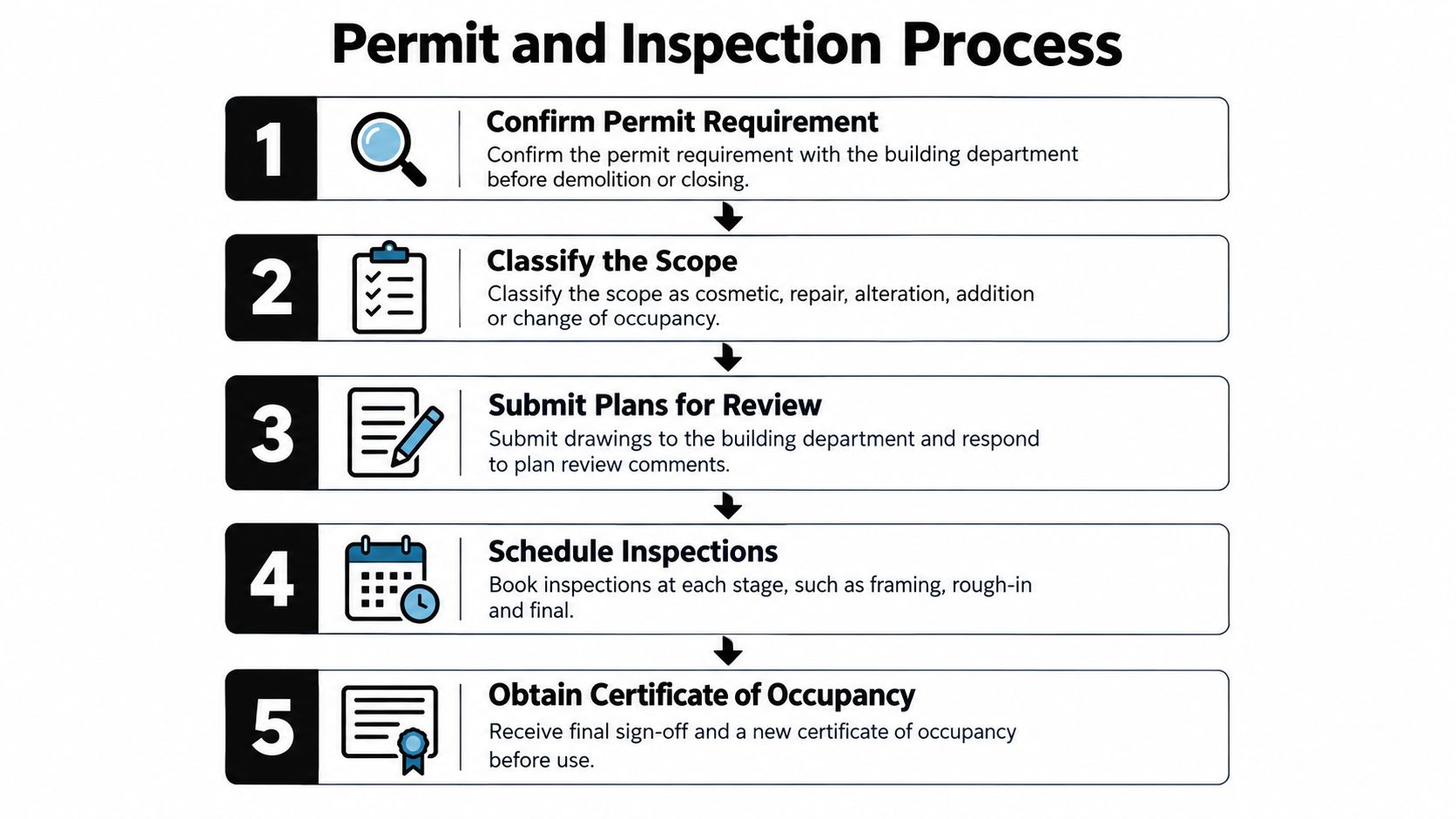

Confirm permit requirements before demolition or acquisition. Send the department a written scope and ask which building and trade permits apply. A verbal description such as cosmetic rehab leaves too much room for misunderstanding.
Classify the work. Identify repairs, alterations, additions, and any change of occupancy. Resolve disputed classifications before ordering materials.
Prepare the submission and name the permit holder. Establish whether the licensed contractor or an eligible owner-builder will apply. Include drawings, calculations, or a scope letter appropriate to the work.
Submit for plan review. Allow for comments, revisions, and resubmittals rather than treating the published review target as the entire approval period. Assign someone to answer reviewer questions.
Keep the issued permit and approved documents available on site. Crews need the approved version, not an older pricing set. Confirm local posting requirements.
Book foundation, framing, and rough-in inspections before concealment. Include applicable plumbing, electrical, mechanical, and fire-resistant penetration checks. These hold points let inspectors see connections and assemblies that finished surfaces would hide.
Arrange insulation and energy inspections at the required stage. Confirm whether testing or supporting documentation is needed. Don't schedule drywall around an assumed pass.
Obtain lath and gypsum-board inspections where required. Fastening and rated-assembly details may need approval before finishes obscure them.
Complete each trade's final inspection. Track corrections individually so a passed building inspection doesn't mask an unresolved electrical or plumbing final.
Obtain the required occupancy or completion approval. Ask which document applies to the project and whether a new or amended certificate of occupancy is necessary. Don't assume every renovation receives a new certificate.
A failed inspection can prevent the affected work from proceeding until corrections are accepted. Reinspection may also create additional fees, contractor remobilization, and carrying time.
This video provides another reference for discussing the process with your project team.
For a rebuild, compare the permit schedule with the financing structure. LendingXpress's discussion of bridge financing for teardown projects can help frame questions about funding during redevelopment; confirm actual draw conditions and extension terms with the lender.
Violations can surface after a project appears finished, during an inspection, a lender's review, or a buyer's investigation. The expensive part isn't always the defective component. It's gaining access, documenting the correction, and getting approval to proceed.
Common rehab violations, fixes, and planning impact
| Violation | Common Cause | Typical Fix | Planning Impact (Directional) |
|---|---|---|---|
| Unpermitted addition or converted garage | Prior owner built without approval | Retroactive application, design review, and possible opening of finished surfaces | Extended review exposure; include investigation, design, and reconstruction |
| Missing or undersized egress window | Sleeping room created without an adequate escape opening | Approved opening, well, and clear escape path where required | Structural cutting and exterior work can expand the scope |
| Outdated electrical or undersized service | Legacy wiring, unsuitable equipment, or DIY circuits | Electrician-defined service, wiring, and protection corrections | Utility coordination may control completion |
| Improper plumbing vent or drain slope | Rough-in installed without adequate review | Re-piping or re-venting, potentially through finished floors | Include access, testing, inspection, and finish restoration |
| Undersized headers or missing hangers | Structural work completed without suitable detailing | Engineer-designed reinforcement or replacement | Engineering and approval precede concealment |
| Inadequate garage-to-dwelling separation | Conversion or remodeling damaged required protection | Approved wall, ceiling, door, and penetration corrections | Price the complete assembly, not drywall alone |
| Missing smoke or CO alarms | Devices omitted or incorrectly located | Install the locally required devices and connections | Limited physical work can still prevent final approval |
| Unpermitted HVAC or gas work | Installation outside the required approval process | Permit, equipment verification, calculations, and testing as applicable | Equipment availability and testing can extend closeout |
These are planning categories, not local bids or guaranteed durations. Obtain a written correction scope before assigning a budget.
Older homes deserve an electrical review for legacy wiring, service capacity, and required protection. Age alone doesn't establish a violation or require wholesale replacement. The electrician needs to distinguish an unsafe condition, an existing installation permitted to remain, and an upgrade triggered by your proposed work.
Prior-owner additions create a different problem: you may need to establish whether the space can be approved at all. Don't price legalization as a permit fee when the room's structure, ceiling height, ventilation, or exits remain unresolved.
Construction shortcuts require another response. A missing hanger might be a localized correction; an undersized header could require temporary support, engineering, and reconstruction. Price the repair sequence, not just the replacement part.
Austin's Development Services Department reported that 86% of single- and multifamily residential building-code violation cases were resolved after the initial notice in FY 2023, according to its annual report. That measures case resolution, not a standard repair duration.
Budget for notice review, correction, and verification. If a case remains open after the initial response, ask what remains unresolved before assuming the seller forgot to close it.
An empty violation record isn't proof of compliance. An unreported conversion may not appear in enforcement records, even when it is visible during a walkthrough. A jurisdiction's adoption of a code does not establish that a particular property was built to it. Check the property's own permit and inspection history.
Look for discrepancies that warrant follow-up, rather than treating one feature as a verdict:
Review the roof as part of the physical inspection. HIBCO ROOF's buyer inspection guide covers roof-specific purchase due diligence. Reconcile any condition findings with repair and permit records.
A broader property condition assessment can help organize questions for specialists. It evaluates physical condition; a municipal records search establishes permit and inspection status. Use both, since neither answers the other's questions.
PropLab pulls property data from public records, tax assessments, and market data without requiring MLS access. Its Rehab Cost Calculator produces a line-item repair budget with contingency, while its 70% Rule Calculator gives a maximum offer based on ARV and repairs. Use those estimates alongside municipal records and specialist findings, not in place of them.
Before removing contingencies, request the seller's inspection reports, approved drawings, and system warranties. A permit on file is a starting point for due diligence, not confirmation that the work passed inspection or complies.
Start with the screening formula:
Maximum allowable offer = ARV × 70% − repairs.
That's an investor rule of thumb, not a legal standard or a guarantee of profit. For a clearly hypothetical property, assume $300,000 ARV and $60,000 in ordinary repairs. The resulting base MAO is $150,000, before separately identified compliance exposure.
The adjustment is straightforward:
Adjusted MAO = base MAO − additional compliance cost − additional carrying cost.
The table below uses hypothetical assumptions, not market prices: a monthly holding cost of $1,800, with assumed added durations for each scenario. Replace every assumption with contractor bids, consultant fees, lender terms, and the expected local approval schedule.
How compliance findings change an illustrative MAO
| Scenario | Added Compliance Cost | Added Carry | Adjusted MAO |
|---|---|---|---|
| Clean permit history, all work closed | $0 identified | $0 additional | $150,000 |
| Unpermitted bathroom needing retroactive permit | $6,000 assumed | $1,800, assuming one added month | $142,200 |
| Failed framing inspection needing corrective structural work | $15,000 assumed | $3,600, assuming two added months | $131,400 |
| Change of occupancy triggering life-safety upgrades | $30,000 assumed | $5,400, assuming three added months | $114,600 |
| Undocumented electrical service, condition unknown | Not yet established | Not yet established | Price after electrician review |
The clean-record scenario carries no identified additional adjustment. It doesn't justify removing ordinary contingency.
For the bathroom scenario, the assumed allowance covers more than filing paperwork. An actual bid should identify access, correction, testing, and finish restoration. The framing scenario needs an engineered solution before the contractor can offer a meaningful fixed scope.
The occupancy-change scenario can involve coordinated work across multiple systems. An unknown electrical service is different: there's no defensible adjustment until an electrician defines the condition and the utility's involvement.
A contingency covers variability within a defined scope. It shouldn't conceal a scope you haven't established.

The Congressional Research Service summary reports that only about 35% of natural-hazard-prone U.S. jurisdictions had adopted hazard-resistant building codes as of the first quarter of fiscal year 2025. For an older property, ask which resilience upgrades your project triggers and which remain elective.
Changes of use, added area, substantial renovation, or occupancy approval can bring additional requirements into consideration. Get the department's determination and separate mandatory life-safety work from optional energy or resilience improvements.
Recommended upgrades may still protect insurability, financing options, and long-term value. Evaluate those benefits separately instead of presenting every desirable improvement as a code mandate.
Reprice when inspection findings change. If you can't establish a feasible correction scope within the acquisition timeline, extend due diligence or walk away rather than inventing a discount.

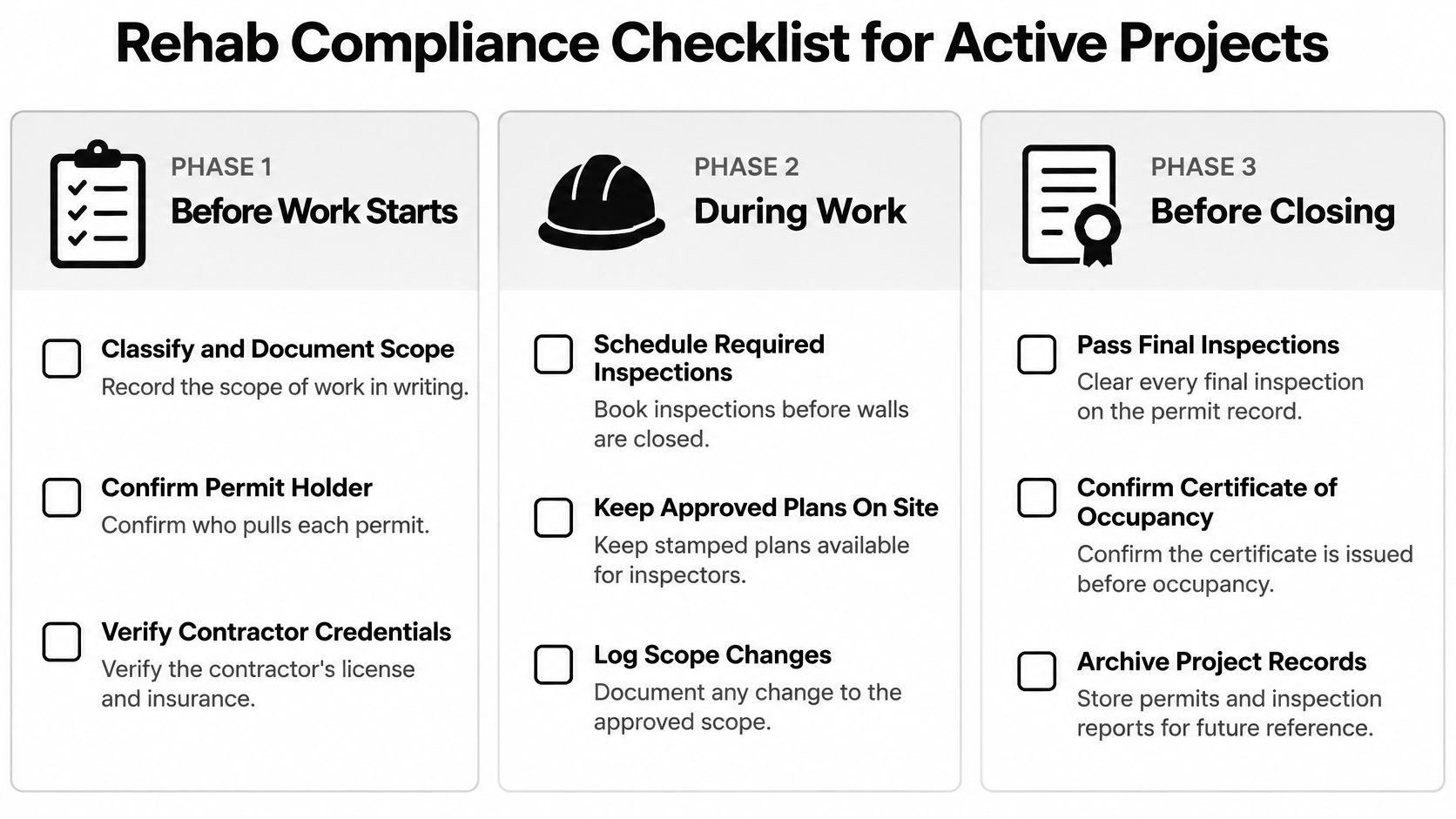

Turn the approved scope into a working record that the contractor, project manager, and owner can use. Assign a named person to maintain it; a shared folder with no owner becomes a collection of incomplete documents.

Every scope line that touches a building system gets an explicit compliance line in the budget. Mark included approval work clearly, identify exclusions, and avoid counting the same correction in both the repair estimate and the compliance adjustment.
PropLab helps you connect property records, comparable sales, repair estimates, and maximum-offer calculations in a shareable underwriting report. Visit PropLab to analyze your next address, then add a separate compliance adjustment based on the permit record, specialist findings, and actual correction bids before making your offer.
The PropLab team consists of experienced real estate investors, data scientists, and software engineers dedicated to helping investors make smarter decisions with AI-powered analysis tools.
Get a line-item renovation estimate from the property details — no contractor walkthrough needed.
Get a line-item renovation estimate from the property details — no contractor walkthrough needed.
